Commercial Loading Modernization Project - Stage One
Updated: November 2026
What's Happening Now?
SDOT Moves on to Stage Two!
Stage One of Seattle’s Commercial Loading Modernization Project (SMART Project) has concluded. In December 2024 the US Department of Transportation (USDOT) via its Strengthening Mobility and Revolutionizing Transportation (SMART) grant program awarded Seattle and Minneapolis Stage Two grant funding to help both cities continue addressing the challenges of managing limited curb space in urban centers.
In Stage Two, we will build on what we learned in Stage One. We will focus on five diverse neighborhoods to produce data-driven neighborhood curb loading plans, continue developing a curb data management platform, and adopt a scaled, data-driven approach to updating city policies to improve curb access.
To find out more about our Stage Two project please visit: Stage Two website.
Project Overview
In April 2023, the US Department of Transportation (USDOT) via its SMART (Strengthening Mobility and Revolutionizing Transportation) grant program awarded Seattle Department of Transportation (SDOT) a $2 million grant to improve commercial vehicle access to the curb. SDOT began work on September 1, 2023, and finished September 1, 2025.
The Stage One project was guided by two main goals:
- Understand commercial vehicle curb access through robust baseline data collection and engaging with local businesses and urban freight companies
- Improve curb access through vehicle-to-curb technology, digital permit, and digital curb measuring tools built on the Curb Data Specification (CDS) standard

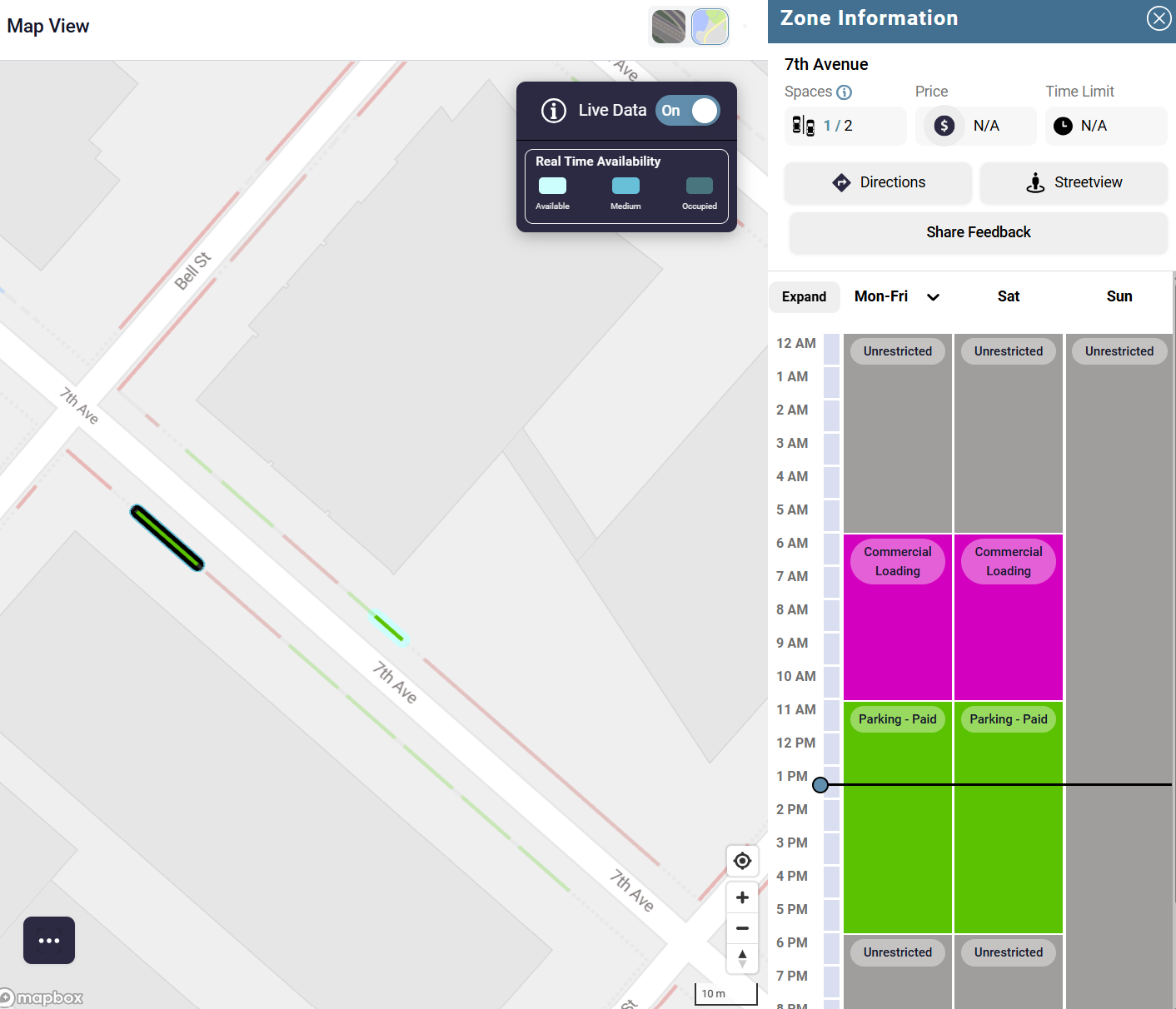

The Stage One project was in Seattle’s Belltown and Denny Triangle business districts. SDOT prototyped a digital commercial vehicle loading permit by digitizing curb regulations, deployed two vehicle-to curb technologies, and engaged with local business and urban freight companies. The project tested whether technologies could build a data-driven commercial loading permit program by measuring zone usage, identifying vehicle types at these zones, permit compliance, and integration capabilities into a larger digital permit ecosystem that could inform citywide policy.
Project Area

Project Schedule
Stage One had a two-year timeline.

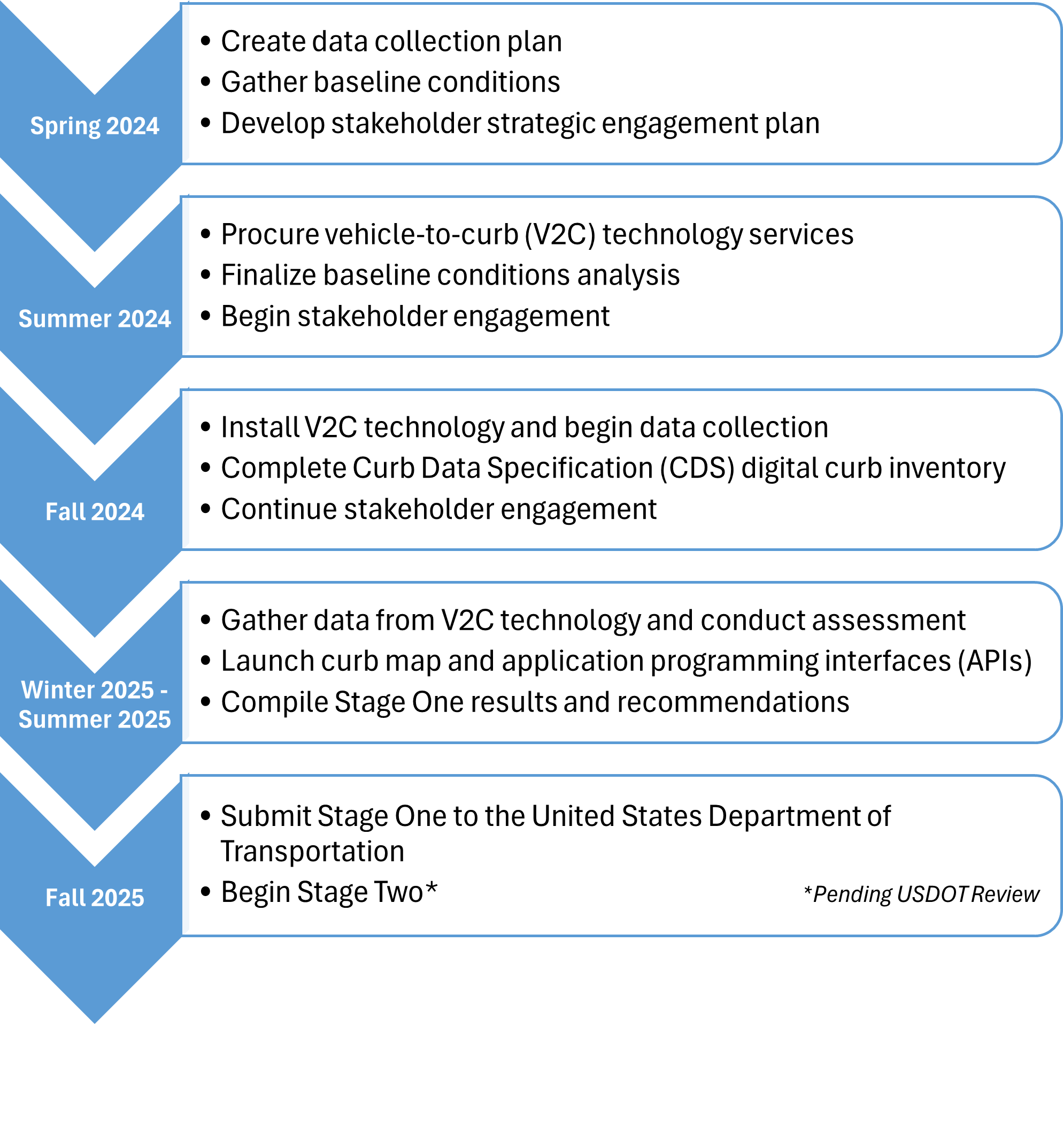

Fall 2023: Planning and project development
Spring 2024: Created data collection plan, gathered baseline conditions, and developed a stakeholder strategic engagement plan
Summer 2024: Procured vehicle-to-curb (V2C) technology services, completed baseline conditions analysis, and began stakeholder engagement
Fall 2024: Installed V2C technology services, completed Curb Data Specifications (CDS digital curb inventory, and continued stakeholder engagement
Winter 2024 - Summer 2025: Gathered data from V2C technology and assessed performance, launched the online curb map and application programming interfaces (APIs), and began to draft Stage One results and recommendations
Fall 2025: Submitted Stage One final report and Stage Two application to USDOT
Project Findings
What Did We Learn?
SDOT learned a lot about commercial loading, digital infrastructure, and what is needed for businesses to load and unload goods at the curb. Stage One highlighted the need for a data-driven, modernized Commercial Load Permit program.
Key takeaways from the Stage One project include:
- Approximately 80% of all the vehicles using Commercial Vehicle Load Zones (CVLZs) were passenger vehicles that are not authorized to use them.
- Businesses interviewed saw management of load zones as a key factor in curbspace value. Many were open to technology being able to assist.
- Vehicle-to-curb technology can be an asset to actively measure CVLZ usage. Several factors including power source, device configuration, and data integration play key roles in its viability.
- CDS data translation is possible, however it is complex based on SDOT’s current data structure. SDOT can begin to make data changes to address some of the challenges.
Our full report can be accessed here: Last-Mile Freight Curb Access: Digitizing the Last-Mile of Urban Goods to Improve Curb Access and Utilization
To access our data, please visit our data repository: Seattle SMART Grant Digital Commercial Vehicle Permit Project | Zenodo
Project Funding
The SMART project is being funded by the United States Department of Transportation’s Strengthening Mobility and Revolutionizing Transportation (SMART) Grants Program. The program was established in the Infrastructure Investment and Jobs Act.
To learn more about the SMART grants program: SMART Grants Program | US Department of Transportation.
Project Partners
Urban Freight Lab at the University of Washington
The University of Washington’s Urban Freight Lab (UFL) brings together private industry, academic researchers, and public transportation agencies to solve urban freight management problems that overlap private and public spaces and have wide-ranging benefits.
UFL led the project’s research by providing commercial vehicle curbside utilization data analysis on curb use behaviors, completing a parking and pricing policy scenario assessment, and leading freight carrier interviews. UFL recently published a paper on their Stage One research. Read about it here.
Open Mobility Foundation
The Open Mobility Foundation (OMF) is an open-source foundation that creates a governance structure around open-source mobility tools. By creating an open-source foundation, OMF offers a safe, efficient environment for stakeholders including municipalities, companies, technical, privacy, and policy experts, and the public to shape urban mobility management tools that help public agencies accomplish their mobility policy goals.
The OMF stewards the development and governance of the Curb Data Specification (CDS). CDS is a digital tool that allows cities to digitally represent their curb space, communicate with curb users in different ways, and use metrics to improve those curbs. CDS is used extensively in the SMART Project.
For more information on CDS, visit their webpage.
SMART Grant Curb Collaborative
OMF led the SMART Grant Curb Collaborative of 10 SMART grant awarded cities who used CDS to implement and manage their grant projects. The collaborative included Seattle, Portland, San Francisco, San José, Los Angeles, Minneapolis, Philadelphia, Boston, Buffalo, and Miami-Dade County. This collaborative was committed to tackling a common problem with similar technologies – specifically to digitally gather and analyze curb information to reduce congestion, enhance livability, and improve safety and equity on city streets.
