N 34th St Mobility Improvements

Updated: April 5, 2021

What’s happening now?

Construction is almost complete at the intersection of N 34th St and Stone Way N and at N 34th St and Troll Ave N.

Diagram of initial work at N 34th St and Stone Way N.
Diagram of work zone

Work in the coming weeks will include the following:

  • Channelization changes on southbound Stone Way N to make the section south of N 34th St a single lane
  • Nighttime channelization changes along N 34th St from Freemont Ave N to Stoneway Way N.

Diagram of detour routes for work on the north side of N 34th St.
Diagram of proposed detour

Diagram of detour routes for work on the south side of N 34th St.

South Detour map



We're committed to working closely with project neighbors during construction and will:

  • Be available for questions via our project inbox and construction hotline
  • Provide advance notice about construction through email updates and other promotions
  • Ensure project signage is clear and effective to encourage safety and caution near active work zones

What to expect during construction

Typical construction hours are weekdays, 7 AM to 5 PM, with occasional weekend and night work. Other expected construction effects may include:

  • Temporary driveway impacts
  • Noise and vibration
  • Dust and debris
  • Construction staging and parking impacts near the work sites
  • Crosswalk and sidewalk closures, and detours for people walking and biking
  • Roadway closures and detours for vehicle traffic
  • Changes in construction schedule due to unforeseen circumstances (i.e., weather, soil conditions, etc.)

Project Overview

Over the last few years, we've worked with the Fremont community to improve transportation in the neighborhood. This project aligns with both the freight and bicycle master plans by enhancing bicycle safety for all ages and abilities while preserving freight access on N 34th St.

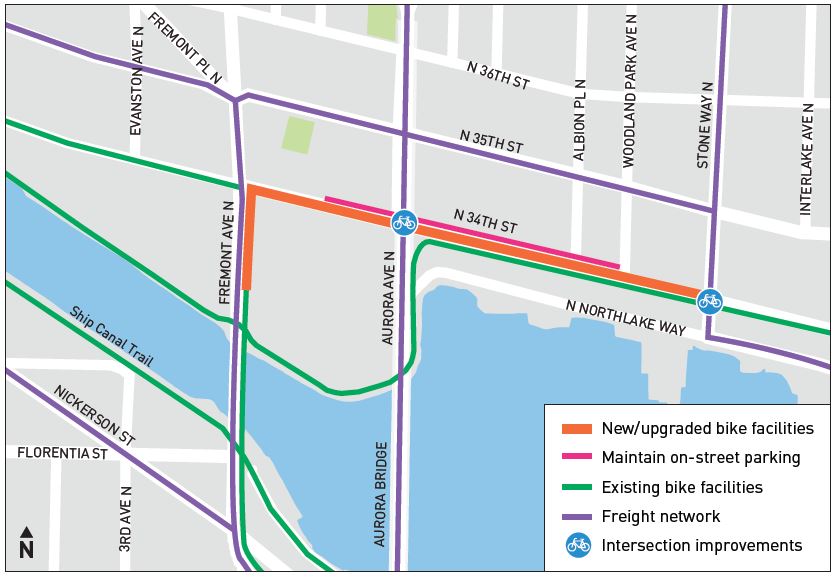

We have completed design for this project and you can review the final project map here.

The design adds protected bike lanes from Fremont Ave W to Stone Way N, maintains parking on the north side of the street, and updates intersection design at the Stone Way N, Troll Ave N, and Fremont Ave N intersections.We developed this design using traffic data, what we heard during previous community outreach, and guidance from our citywide transportation plans to create a path forward for this safety project.We anticipate beginning construction on N 34th St as soon as spring 2021.

Project Details

Project goals:

  • Enhance safety by upgrading the existing bike lane
  • Maintain freight access to support Seattle's demand for goods and services
  • Provide a comfortable and predictable bike connection between the Fremont Bridge and the Burke-Gilman Trail

Design features:

  • Maintaining a travel lane in each direction on N 34th St between Fremont Ave N and Stone Way N
  • Preserving existing on-street parking and load zones
  • Upgrading standard bike lanes to protected bike lanes by adding a painted buffer area between the bike lane and auto traffic with white plastic posts
  • Enhancing safety at the intersections of Fremont Ave N, Troll Ave N, and Stone Way N

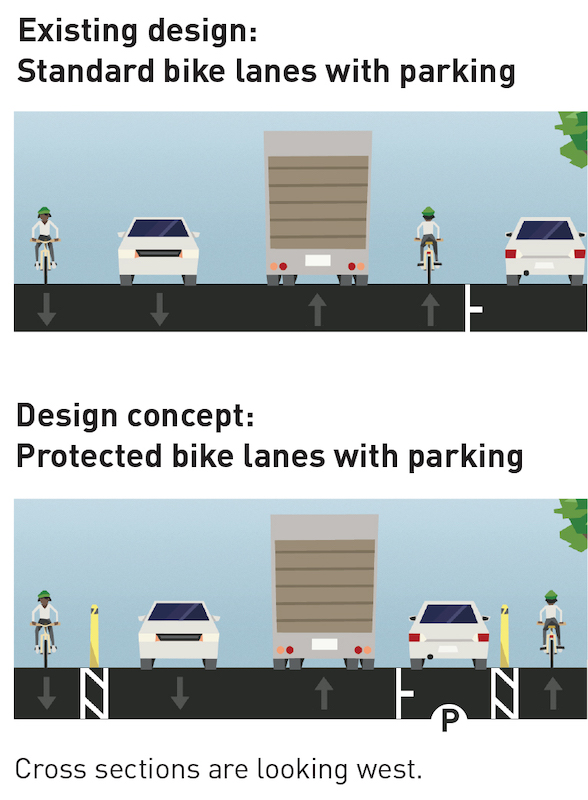

Cross section design

Close up project map showing upgraded bike facility.

60% Design Update

On June 4, 2019, we shared a 60% design concept with the Fremont community at the Fremont Library. The design adds protected bike lanes from Fremont Ave W to Stone Way N, maintains parking on the north side of the street, and updates intersection design at the Stone Way N, Troll Ave N, and Fremont Ave N intersections. We developed this design using traffic data, what we heard during previous community outreach, and guidance from our citywide transportation plans to create a path forward for this safety project. The N 34th Design Update Project Map can be viewed in the Materials section below.

10% Design Concept

In January 2018, we proposed three potential designs for the project area called “alternatives” and began outreach to the Fremont community about how you use N 34th St between Fremont and Stone Way and what you’d like to see in the future.

Alternative 2 has been selected for further design and feedback. This alternative proposes upgrading the existing bike lanes to protected, paint-and-plastic-post bike lanes on N 34th St from Fremont Ave N to Stone Way N, and maintains the existing parking on the north side of the street.

In order to select an alternative, we conducted an analysis to further explore how the options best meet our goals and the impacts associated with each option.

The design process included consideration of:

  • Traffic and signal analysis
  • Parking analysis
  • Public feedback
  • Freight and bike master plans

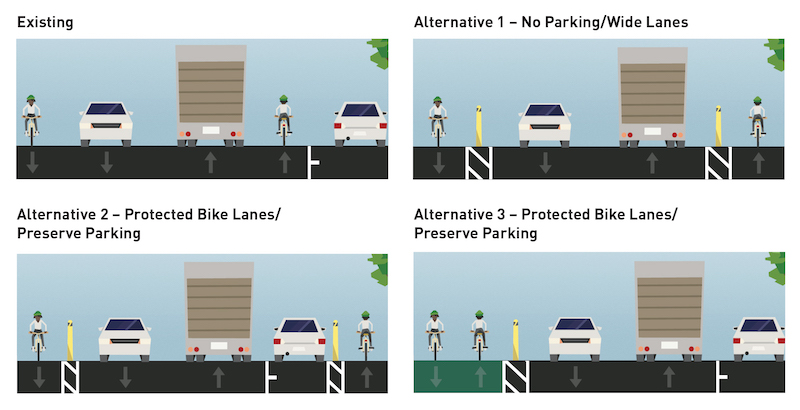

Lane design alternatives

How we incorporated your feedback

In 2017 and 2018, we conducted community outreach to hear from businesses, employees, commuters, residents, and property owners about how they use N 34th St. We used this information to help us make design decisions.

Feedback themes:

On-street parking

We heard preference for maintaining the existing on-street parking on the north side of the street. The preferred alternative maintains existing on-street parking.

Two-way bike facility

We heard preference for a two-way bike facility on the south side of the street. Our traffic and signal analysis indicated challenges for this alternative, including travel time delays for people biking and people driving. We eliminated this alternative due to design challenges and in favor of an alternative that best meets the project goals and budget.

Biking/walking priority

The most common safety issue we heard from community members concerned “failure to yield right of way to people walking or biking.” The Recommended Alternative clarifies the right of way, and make it more predictable and comfortable to walk or bike on N 34th St. This alternative preserve parking and includes 1-way protected bike lanes.

Questions and Answers

Why are you implementing a pair of one-way bike lanes on each side of the street instead of a two-way bike facility on one side of the street?
In the earlier stages of this project's outreach period, we heard community feedback preferring a two-way bike facility to the south side of the street. Our traffic and signal analysis indicated challenges for this design option, including travel time delays for people biking and people driving. We eliminated this option due to design challenges and in favor of an option that better meets the project goals and budget.

Are you making design changes at the intersection of N 34th St and Stone Way N?
At this intersection, we are adding a leading pedestrian interval for the Burke-Gilman Trail, expanding the southwest corner, adding concrete protection to the eastbound bike lane, and adding additional paint to improve safety for people walking and people biking on N 34th St across Stone Way N.What about freight and business access?
We have had extensive conversations with freight and business stakeholders about access and transportation safety on N 34th St and the greater Fremont and working waterfront area. The project design maintains parking and adds passenger loading between Albion Pl N and Woodland Park Ave N. All of the intersections are designed to continue to allow large trucks to move through the corridor.

Schedule

  • 2017-2018: Planning
  • 2019: Design
  • 2021: Construction

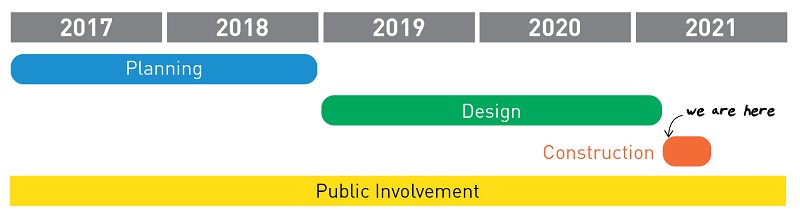

schedule

Materials
