Lander St Bridge

Updated: October 6, 2020

What’s happening now?

The Lander St Bridge opened on October 7, 2020!

After nearly 2 years of construction, and many years of planning, the Lander St Bridge is a reality. People walking, biking and driving can now use this critical connection more safely and efficiently. Read the Project Overview below to learn more about the history and benefits of the bridge and check back here for a video  highlighting the importance of this milestone.

October 6, 2020: SDOT Director, Sam Zimbabwe, and SDOT staff celebrate the completion of the Lander St Bridge
October 6, 2020: SDOT Director, Sam Zimbabwe, and SDOT staff celebrate the completion of the Lander St Bridge

In preparation for the bridge opening, crews have adjusted signals at 1st and 4th avenues S and S Lander St, and removed the temporary signal at 4th Ave S and S Forest St. Please be attentive while traveling through the area as drivers adjust to these changes.

King County Metro buses will return to S Lander St once the bridge opens. Click here for more information about Metro bus service. Routes include 21, 37, 50, 116, 118, and 119.


For work completed check out our construction email update archive and our major milestone project email archive.

View the time-lapse below to see how far we've come!

Project Overview

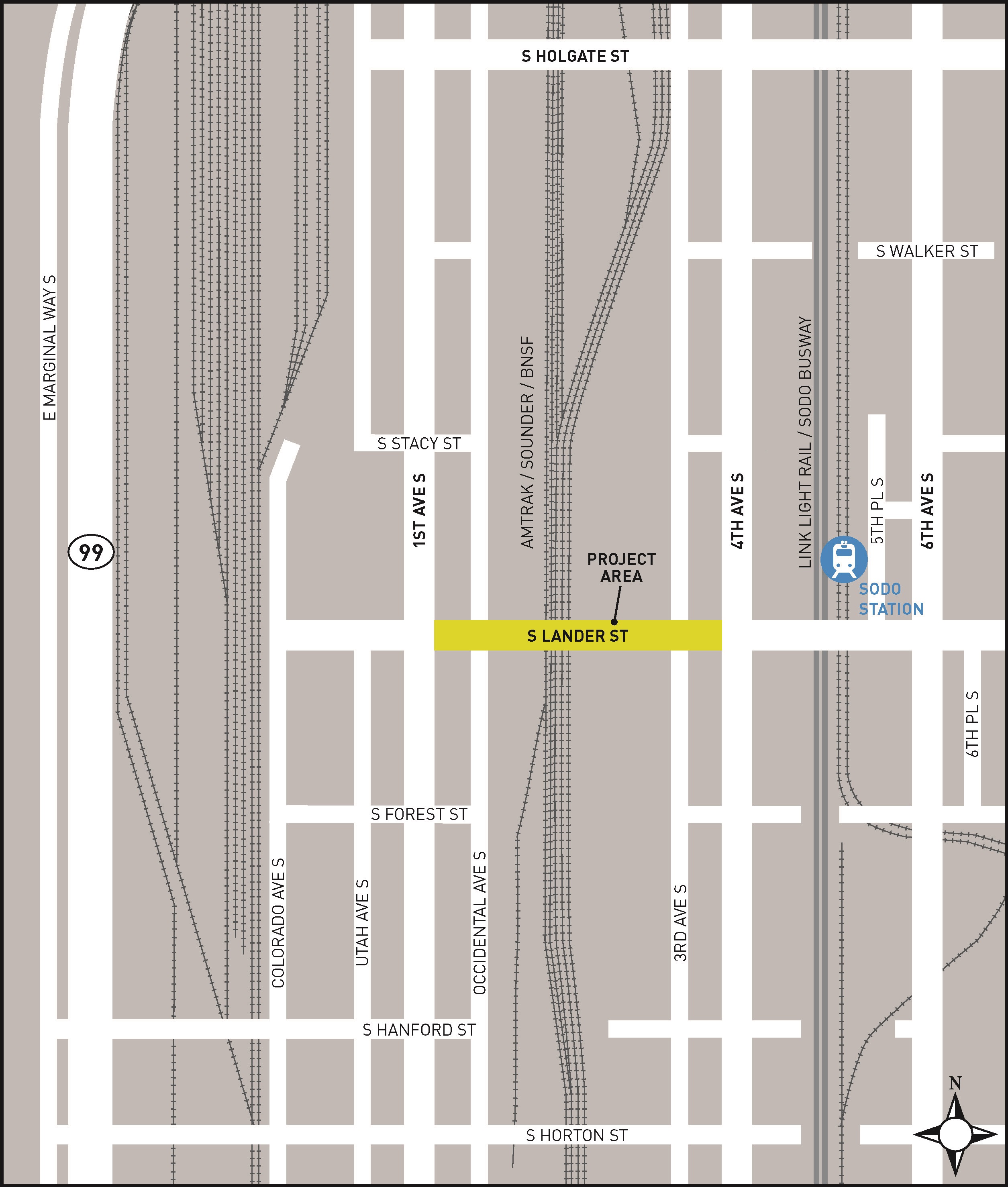

Map of S Lander St Bridge

South Lander St is an essential east-west connection in Seattle's SODO neighborhood. Every day, the street serves over 13,000 vehicles, 1,400 pedestrians, 100 bicyclists, and needs to be closed over 100 times per day for train crossings. Prior to the Lander St Bridge, this active train crossing caused frequent traffic delays and posed a potential safety risk, especially for people walking and biking. As the region continues its rapid growth and rail operations in the area expand in the coming years, the S Lander St "bottleneck" put the Pacific Northwest's economic vitality at risk.

To improve local traffic circulation, rail operations, and safety, SDOT built the Lander St Bridge over the railroad tracks on S Lander St between 1st Ave S and 4th Ave S. This crossing provides a roadway unimpeded by rail operations, improve safety, and relieve congestion in Seattle's SODO neighborhood.

Project Cost and Funding

The total project cost estimate is $100 million, with contributions from the Levy to Move Seattle, City of Seattle and other project partners, including the U.S. Department of Transportation, the State of Washington, Port of Seattle, and BNSF Railway. The total project cost estimate was revised from $123 million based on the actual bid amount and property purchase needs.

Schedule

We've been working on the Lander St Bridge project since 2016 and after 2 years of construction we're excited to see the bridge open.

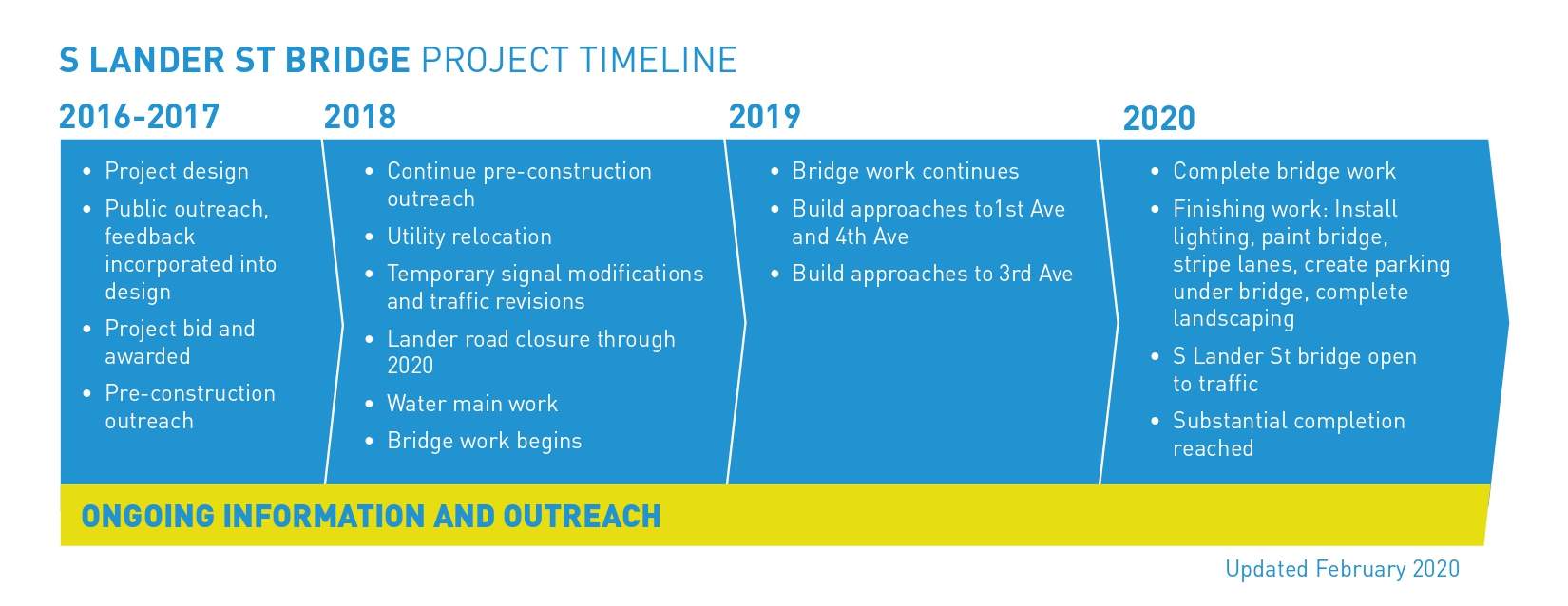

Graphic of timeline, which is written out below
Click to enlarge

2016 - 2017

  • Project design
  • Public outreach, feedback incorporated into design
  • Project bid and awarded
  • Pre-construction outreach

2018

  • Continue pre-construction outreach
  • Utility relocation
  • Temporary signal modifications and traffic revisions
  • Lander road closure through 2020
  • Water main work
  • Bridge work begins

2019

  • Bridge work continues
  • Build approaches to 1st Ave and 4th Ave
  • Build approaches to 3rd Ave

2020

  • Complete bridge work
  • Finishing work: Install lighting, paint bridge, stripe lanes, create parking under bridge, complete landscaping
  • S Lander St Bridge opens to traffic after construction is completed

Frequently Asked Questions

Why is this project important?

The S Lander St Bridge will enhance mobility in this critical freight corridor and improve safety for people walking, biking, and driving.

How will the project create more reliable freight movement?

The bridge will create reliable access adjacent to one of the largest port operations in the United States. It will improve safety for the more than 3,000 freight rail cars per day on the tracks, and reduce truck delays, congestion and emissions for more than 13,000 vehicles each day including 1,400 surface freight trucks per day. This project will improve the reliability of the last-mile connections between the interstates and the Port of Seattle and area manufacturing in the Duwamish Manufacturing Industrial Council (MIC), the largest MIC in the state.

How will the bridge benefit people walking and biking?

The new bridge will feature a 14-foot walking/biking path on the north side of the bridge that is physically separated from the road. The bridge approaches will also include new curb ramps that meet current standards for accessibility.

Will this project address safety and access in the SODO neighborhood?

The project will increase safety by separating trains from people walking, biking, and driving and creates an unimpeded access point for emergency responders. The bridge also provides access between regional transit hubs and employment centers.

Materials

State Environmental Policy Act (SEPA) Review

The Seattle Department of Transportation (SDOT) determined that the S Lander St Grade Separation and Railway Safety Project will not have a probable significant adverse impact on the environment. As a result, SDOT issued a Determination of Non-significance on May 11, 2017. The DNS, Categorical Exclusion Worksheet, and supporting documents may be examined through the links below.

DNS
Categorical Exclusion Worksheet
Introduction and Project Description
Cultural Resources Assessment
Hazardous Materials Discipline Report
Noise Discipline Report
Visual Impact Assessment
Social Effects and Environmental Justice Discipline Report
Transportation Discipline Report
