Lowman Beach Park Seawall

Updated: January 4, 2022

Early 2022

Mike McClung Construction has reached a milestone with the project. Two main components of this project are complete: demolition of the existing failed concrete seawall, and drilling and installation of the steel piles that provide structural support for the new seawall. This return segment of new seawall will protect the neighbor's seawall to the north while rest of the site is designed to mimic a natural backshore. The next critical phase of work is installation of the new precast concrete seawall, scheduled to occur between January 11 - 24, 2022.

The installation will be challenging, because this work must be completed at workable low tides and before the in-water work window closes on February 15. The time limitation for work below the ordinary high water line is to protect fish and shellfish habitats at the job site per Washington Department of Fish and Wildlife. The workable low tides in January and February occur outside normal working hours. In order to meet permit requirements and accommodate physical tidal challenges, we will have to work at night for seawall installation and complete beach grading by February 15 deadline.

The seawall installation requires a 10-foot deep excavation that must be shored to prevent cave-ins and to support an existing structure. Additional care must be given to the existing structure because the required excavation depth is deeper than the bottom of the existing structure's foundation. Once excavated, a crane will swing in the 20,000-pound precast concrete wall components, which will then be welded in place. This portion of the work will require workers to physically be in the excavated and shored hole. Due to the high risk, magnitude, and unique existing site conditions of this work, we must perform the excavation and installation of the new seawall in a safe and dry environment, when the tide is at its lowest point.

Two work windows at low tides will be needed to complete the seawall installation:

  1. Preparing for the permanent installation of new seawall segments - This will require up to four nights of work,  but could possibly be completed in one or two nights.
  2. Installing the precast wall panels - This is expected to take another three to four nights of work.

Our Temporary Noise Variance Permit is currently approved for work between 7 PM and 7 AM starting Tuesday, January 11, 2022 at 7 PM and stopping no later than Tuesday, January 25 at 7 AM.

Although the permit allows for 14 nights of work, we expect to work a maximum of eight night shifts. We will do what we feasibly can to mitigate the inconvenience we are causing: to keep noise levels down as much as possible, we'll disable backup alarms, and perform no high-impact work. Depending on conditions, it might be necessary to adjust our permit window by a day or two, but we will make every effort to stay on schedule and minimize noise disturbance to the surrounding neighbors while we complete this critical stage of the project as safely and efficiently as possible.

Seattle Parks and Recreation awarded the construction contract to Mike McClung Construction. They mobilized on site after Labor Day 2020 and partially closed the park. Closure includes beach access, tennis court and trail access. Public access to a portion of the lawn and playground area will be maintained. See larger photo of closure area.

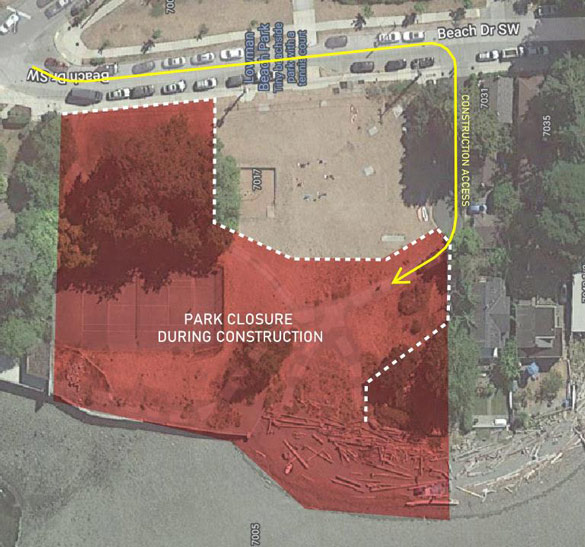

Aerial view map of park showing area closed during seawall project construction. Red area is closed portion of park.

View the Seawall Landscape Plan here

Location

Lowman Beach Park, 7017 Beach Drive SW, 98136

Budget

Funding for the feasibility study and design of the project came from State and local grants: $400,000 from the King County Flood Control District's Cooperative Watershed Management Fund (CWM) in two grants and $200,000 from the State's Salmon Recovery Funding Board. We received an additional $450,000 from King County's CWM Fund and $500,000 from the State's Aquatic Lands Enhancement Account to fund the construction of the project.

Schedule

Planning & Design: 2017 - May 2021
Bidding: Late Spring - Late Summer 2021
Construction: Late Summer 2021 - Spring 2022

Project Description

The goal of this project is to remove the remainder of the failing seawall and continue shoreline restoration work that began when the south half of the seawall failed in the mid-1990's.

Lowman Beach Park will be partially closed during construction including closure to the beach access, tennis court and trail access. The project will maintain public access to the lawn and playground area.

Community Participation

Public Meeting February 2019
February 28, 2019 Preliminary Design Presentation
February 28, 2019 Meeting Notes
February 28, 2019 Meeting Poster

In May 2017, together with our design consultant Environmental Science Associates (ESA), SPR presented a feasibility study with three design options to address the failing seawall.
May 31, 2017 Preliminary Feasibility Study Presentation
May 31, 2017 Lowman Beach Design Alternatives

November 2015, Thanksgiving Storm - seawall begins to fail and tilt waterward.

Project Design and Environmental Documents:

2020 Lowman Beach Park 90% Design Plans
2020 Lowman Beach Park 90% Design Basis of Design Report
    • Appendices - 90% Design Basis of Design Report   · Appendix A    · Appendix B    · Appendix C    · Appendix D    · Appendix E     · Appendix F     · Appendix G    · Appendix H

2019 Lowman Beach Park 60% Design Plans
2019 Lowman Beach Park 60% Design Basis of Design Report

2019 Lowman Beach Park 30% Design Plans

In September 2019 Seattle Parks and Recreation (SPR) determined that the project does not have a probable significant adverse impact on the environment. An environmental impact statement (EIS) was not required under RCW 43.21C.030(2)(c). This decision was made after review of a completed environmental checklist and other information on file with SPR. The Determination of Non-Significance (DNS) was issued on September 12, 2019 and is available below.   In February 2019 SPR presented the preliminary design (30% design) for the Lowman Beach Park Restoration and Seawall Removal project. The preliminary design takes into consideration both the habitat benefits of the seawall removal and the coastal engineering ramifications of that seawall removal. Given the design constraints of the project, the existing tennis court will be removed. A remnant of Pelly Creek that currently flows under the seawall will be daylighted as part of the project.
2019 SEPA Determination of Non-Significance

2017 Lowman Beach Feasibility Study
2017 Lowman Beach Feasibility Study - Geotechnical Evaluation

2016 Lowman Beach Park Survey
